MS Project : Setting Up Overtime Pay Rates and Assigning Resource Overtime Hours

I will explain how can you assign overtime hours and overtime Pay Rate to Resource in MS PROJECT 2010

First I will add TASK 1 with 5 days duration:


Now I will add Mary as a resource with $100/hour as standard pay rate, and $150 / hour as overtime pay rate:


Now I will assign Mary to the TASK 1:


You can see $400 in the Cost field (5 days X 8 hours/day X $100 / hour = $4.000)

Now, I will choose the Gant chart view open the Task form ad a detailed view:


I will click ANYWHERE in the Task Form and then I will click on the Format Tab, in the Details Group –> WORK:


Now I will put 16 hours in the Overtime work field. It means that Mary will work 16 hours overtime:

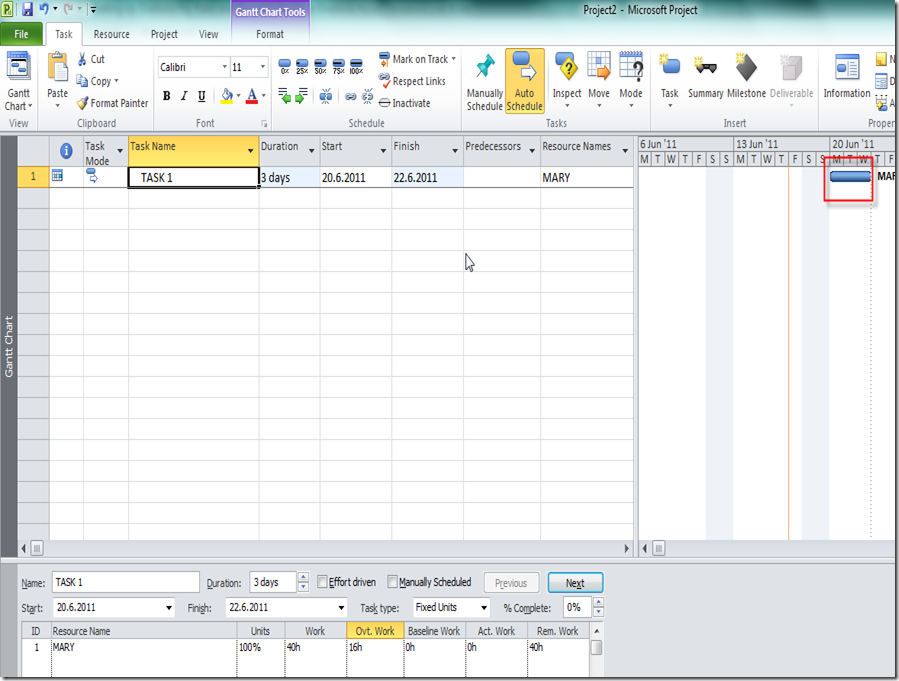

It seems like nothing happened in the Gant chart? I will now click anywhere in the Gantt chart portion of the screen and I will get:


You can see that TASK 1 will have only 3 days duration. Why? Well, if you add overtime work on the task the same amount of work will be done but in shorter period.

I will now close the Task form:


and I will open the Resource usage sheet:


You can see 40 hours that in the Work field. Why? Because initially TASK 1 had 5 days duration (e.g. 40 hours). By adding 16 hours as overtime, TASK 1 will not last 40+16 = 56 hours, but those 40 hours will be done in shorter period.

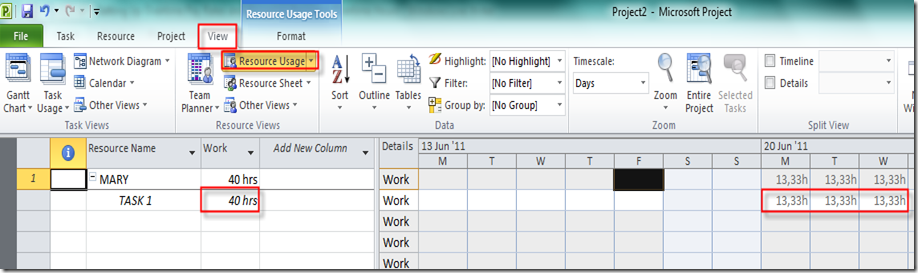

Why 13.33 hours/day? 40 hours of total work – 16 hours of overtime work is 24 hours. 24 hours divided by 8 hours regular work per day is 3 days. O.K. we have 3 days duration. And Mary will work 8 hours each day (regular work) and (16 hours of total overtime / 3 days) = 5.33 overtime hours per day. So, 8 + 5.33 = 13.33.

Now, I will open the Cost table:


And I will get


Why? Well, Mary will work 40 hours on the TASK 1. 24 hours is regular work, and 16 hours is overtime work. 24 X $100 (standard rate per hour) = $.2400, 16 X $150 (overtime rate per hour) = $2.400. So, the total cost fore the TASK 1 is $2.400 + $2.400 = $2.800.

Overtime work is complicated, so you should use it with caution!

quoted by

SISINDOTEK - IT Training & Solution Provider

Office 1 : Jl. Pelajar Pejuang 45 No.23 , Lt.2 Bandung - Jawa Barat

Office 2 : Jl. Sukasenang VI-6B Bandung - Jawa Barat 40124
Tel. 022-71242266, SMS. 0812.8733.1966
info , YM. sisindotek
www.sisindotek.com , facebook.com/sisindotek , twitter.com/sisindotek

Please consider your environmental responsibility.
Before printing this e-mail message, ask yourself whether you really need a hard copy.

"All information in this message and attachments is confidential and may be legally privileged. Only intended recipients are authorized to use it. E-mail transmissions are not guaranteed to be secure or error free and sender does not accept liability for such errors or omissions. The company will not accept any liability in respect of such communication that violates our e-Mail Policy."

Comments

Popular posts from this blog

Trainer Primavera P6 Project Management or Methodology Management

Hery Purnama 081.223344.506 is a Freelance Inhouse Trainer for Primavera P6 Project Portfolio Management , 15 years experience as Project Management Concept , MS. Project , Primavera P6 freelance Trainer Inhouse trainer for location in Bandung, Jakarta, Bali, Yogya, Batam, Medan, Balikpapan, Samarinda, Makasar, Surabaya and other cities in indonesia For inquiry please Call/ SMS/ Whatsapp to 081.223344.506 , email : purnamainfo or visit http://freelance-it-trainer.blogspot.com , http://good.web.id

Wow !, #infoproperti withdrawal complete : syahrul, Rp 840000, 2017-02-21 [token:963]

Wow Luar biasa !, agen Syahrul Rahmat Hadi telah sukses menarik komisinya untuk ke sekian kalinya sebagai member dari Program Agen Milyuner www.propertilink.com sebesar Rp 840000 pada tanggal 2017-02-21 (YYYY-MM-DD) , Apakah Anda berikutnya ?, Ikuti jejak agen Syahrul Rahmat Hadi di www.propertilink.com, daftar sekarang dan posting iklan properti Anda sepuasnya tanpa batas serta raih pasif income yang sesungguhnya dan mengalir terus tak terbatas dengan bantuan mesin promo otomatis kami. (kami yang pertama memperkenalkan teknologi mesin promo otomatis di Indonesia !). Program Agen Milyuner ini Terbuka untuk siapapun Ingin beriklan properti gratis ?, tersedia juga di www.propertilink.com , ayo jadi yang terdepan , semangat langkah Anda menentukan masa depan Anda dan keluarga ! #agenmilyuner #iklanproperti #iklanpropertigratis #propertilink #agenproperti #jualsewaproperti [Message Server propertilink dot com security token:963], Automatic Engine

TRAINER IN JAKARTA - ITIL V.4

What's new in ITIL V.4 ITIL 4 is the latest version of the ITIL framework and was released back in February 2019. It is highly value-centric, primarily focusing on bringing different stakeholders in an organization together to co-create value for the end-users. With the arrival of new frameworks like VeriSM, SIAM, and FitSM in the IT service management landscape, there was a need for the previous version of ITIL (ITIL v3) to become more refined in the way it approaches service management as an enabler for businesses. ITIL 4, the current version of ITIL takes the best parts of ITIL v3, enhances them, and creates a framework that focuses more on delivering tailor-made solutions for organizations. The previous versions of ITIL directed practitioners to implement ITIL by the book which led them to a complex web of practical solutions. Whereas ITIL 4, is more pragmatic in this approach. Instead of idealizing processes and encouraging the practitioners to impl...
